📰 BK Enterprise Inc. – Project Highlights Newsletter
September 2025 Edition Featuring Key National Infrastructure Initiatives
BK Enterprise Inc. has successfully submitted the 100% design package for the Electrification of Redemption Hospital. This transformative project will bring reliable power to one of Liberia’s leading healthcare institutions.
🔧 Project Features
Full electrical infrastructure upgrade
Energy-efficient systems and solar readiness
Compliance with U.S. and Liberian safety standards
Noise and air pollution control for hospital safety
🌍 Environmental Protection
An Environmental Protection Plan (EPP) ensures responsible waste disposal and reduced risks.
🧑🔧 Community Impact
Skilled job creation and technician training.

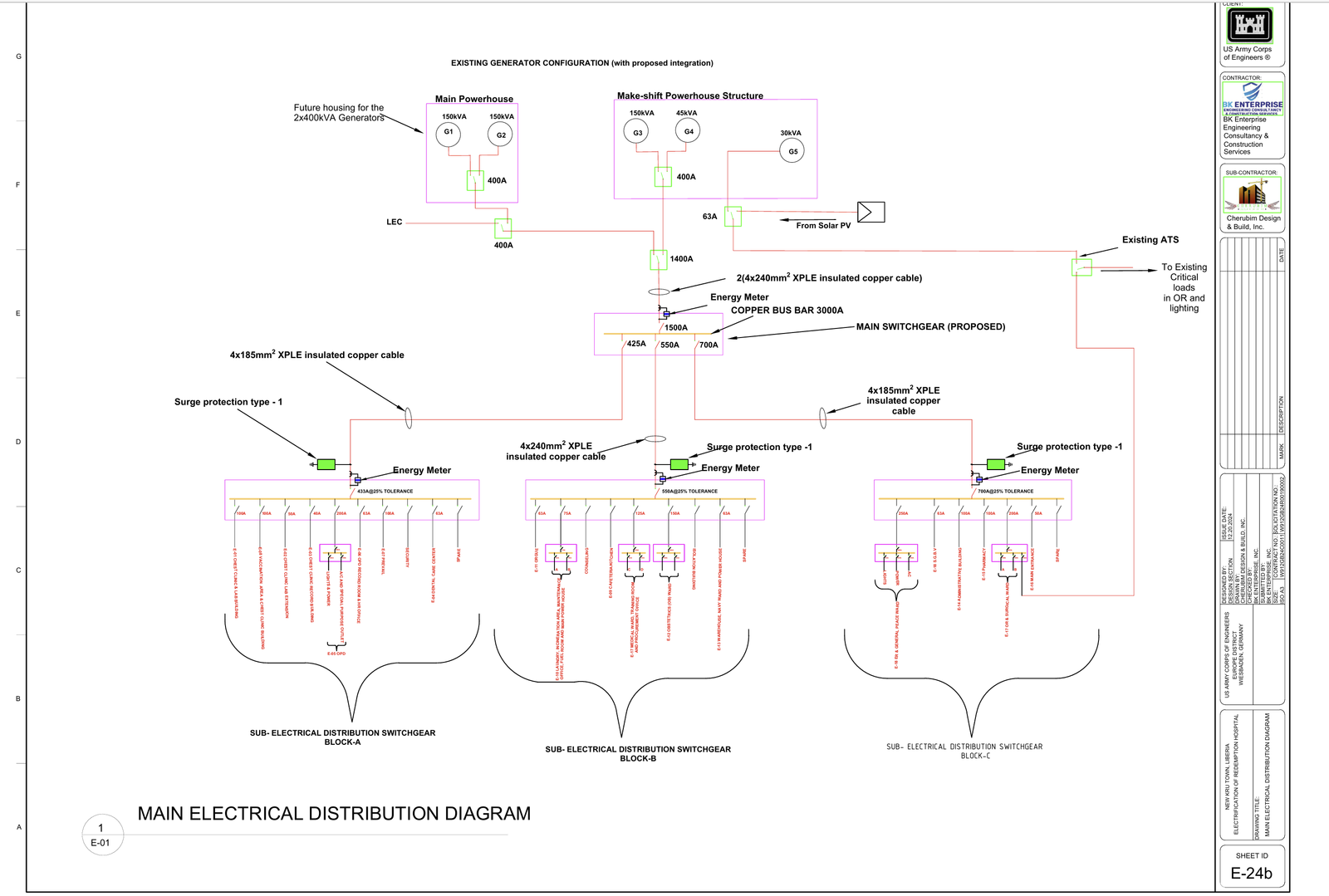

Electrical Drawing
📌 Progress Update – September 2025
✅ Social Component
Community entry completed across all VAR communities in Nimba
CMC Formation: Gbelay Geh – 100%, Zoe Bor - 100%, Sanniquellie Mah – 50%, Doe – ongoing
Labor profiling completed in all 6 communities of Gbelay Geh
CBO formation for Gbelay Geh & Zoe Gbor - ongoing
✅ Technical Component
Detailed survey across ~90 km fully completed
BOQ submitted for Gbelay Geh & Zoe Gbor Districts
Design & BOQ preparation ongoing for Sanniquellie Mah, Zoe-Gbao & Doe
Procurement plan for Gbelay Geh District (CBO No. 1) submitted, pending review & approval
✅ MCA Activities
Workshops held in Sanniquellie-Mah (Aug 11) & Zoe-Geh (Aug 12)
Mobilize construction works in line with Client’s September schedule
Strengthen CMCs & CBOs for community participation
BK Enterprise, Inc TMC Nimba
Project Name: Construction of 8M Reinforced Concrete Bridge
Client: Ministry of Agriculture, TCEP I Location: Rlekporlay Town – Bayleglay Commissioner Camp Corridor Duration: Four Weeks
🎯 Objectives
Construct an 8-meter reinforced concrete bridge to improve rural connectivity along the Rlekporlay–Bayleglay corridor.
Support agricultural development by facilitating farm-to-market access for goods and produce.
🚧 Progress (as of September 2025)
✔ Casting of lean concrete for abutments – Completed
✔ Steel work & formwork for abutments and wingwall footings – Completed
✔ Casting of footing of abutments & wingwalls – Completed
✔ Steel work & formwork of abutments and wingwalls – Completed
✔ Casting of abutments and wingwalls – Completed
✔ Formwork, steelwork & casting of girders – Completed
🔨 Steel work for slab – Completed
🔨 Formwork for slab – Completed
⏳ Casting of slab – Completed
⏳ Finishing work (removal of form & opening of waterway) –Completed

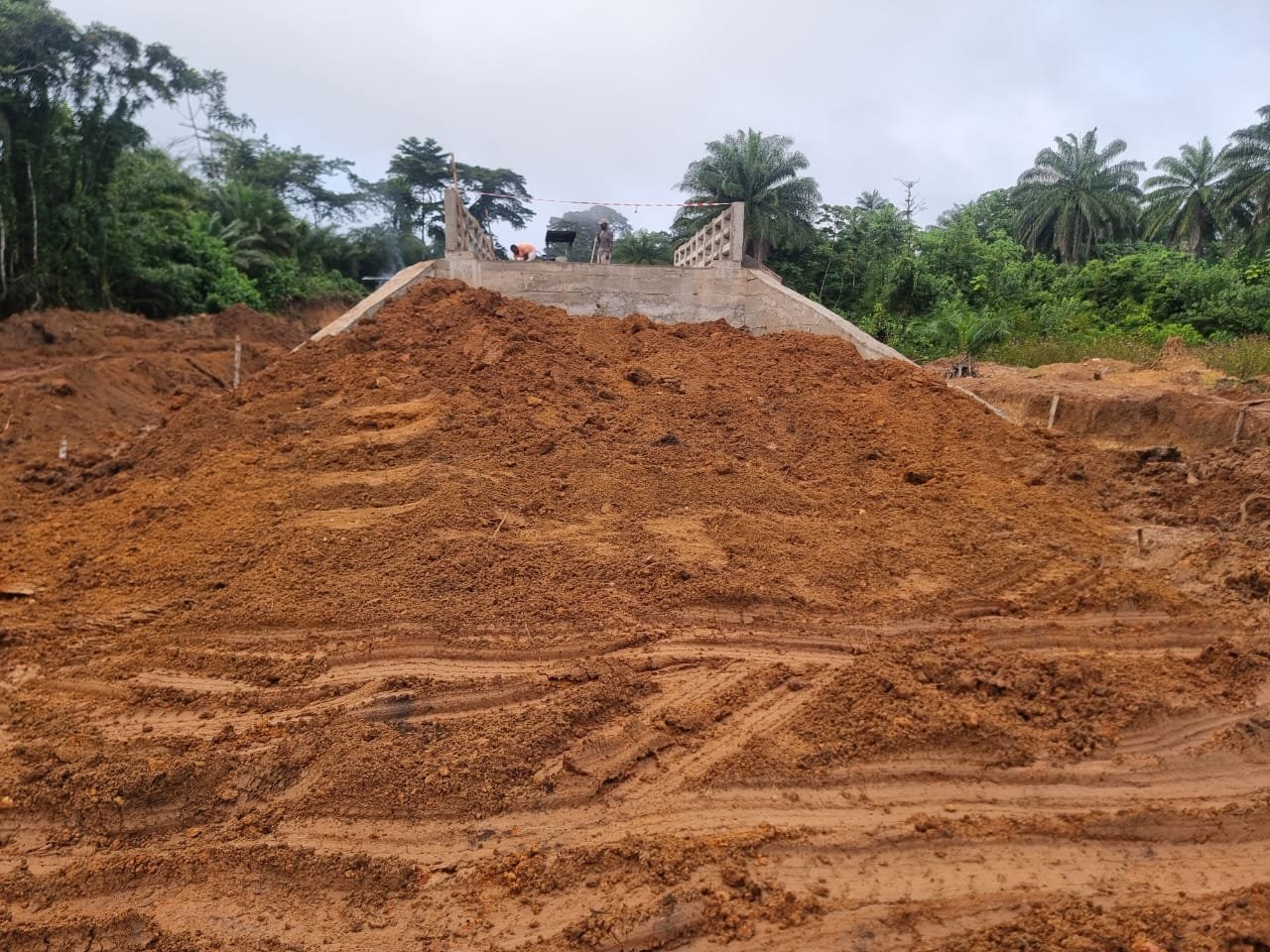

Bridge Works
Project Overview: Part of the Liberia Urban Resilience Project (LURP), this initiative addresses potholes, overlays, and drainage rehabilitation across Central Monrovia and Caldwell.
✅ Key Activities (August 2025)
Drainage cleaning across 10 major corridors (Center St, Lynch St, Newport St, Sekou Toure Ave, Benson St, Buchanan St, McDonald St, Carey St, Camp Johnson Rd, Old CID Rd)
Solid waste collection & disposal at Whein Town landfill
Community engagement & safety toolbox talks conducted
Hazardous areas barricaded; signage installed
🌍 Environmental & Social Benefits
Improved water flow, reduced flooding, safer mobility, cleaner environment, and public health benefits.
🦺 Health & Safety
Zero major incidents reported
100% PPE compliance
Weekly toolbox talks & training sessions held

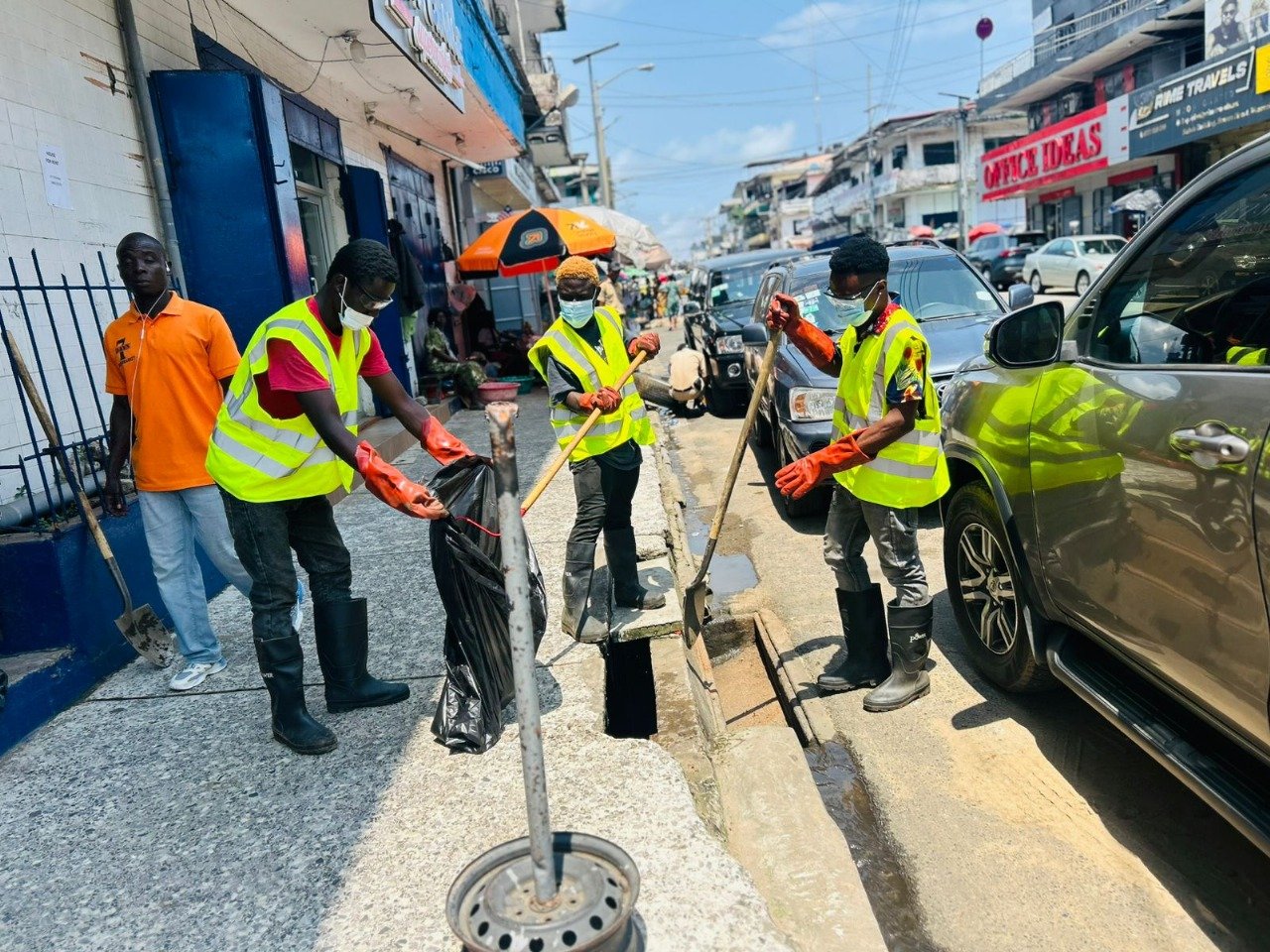

Drainage Cleaning – Benson Street
BK Enterprise Inc. proudly announces the substantial completion of consulting services for the Detailed Engineering Design, Specifications, BOQ, Bidding Documents, ESIA, ESMP, and RAP of the 110KM Kelipo–Zwedru road corridor.

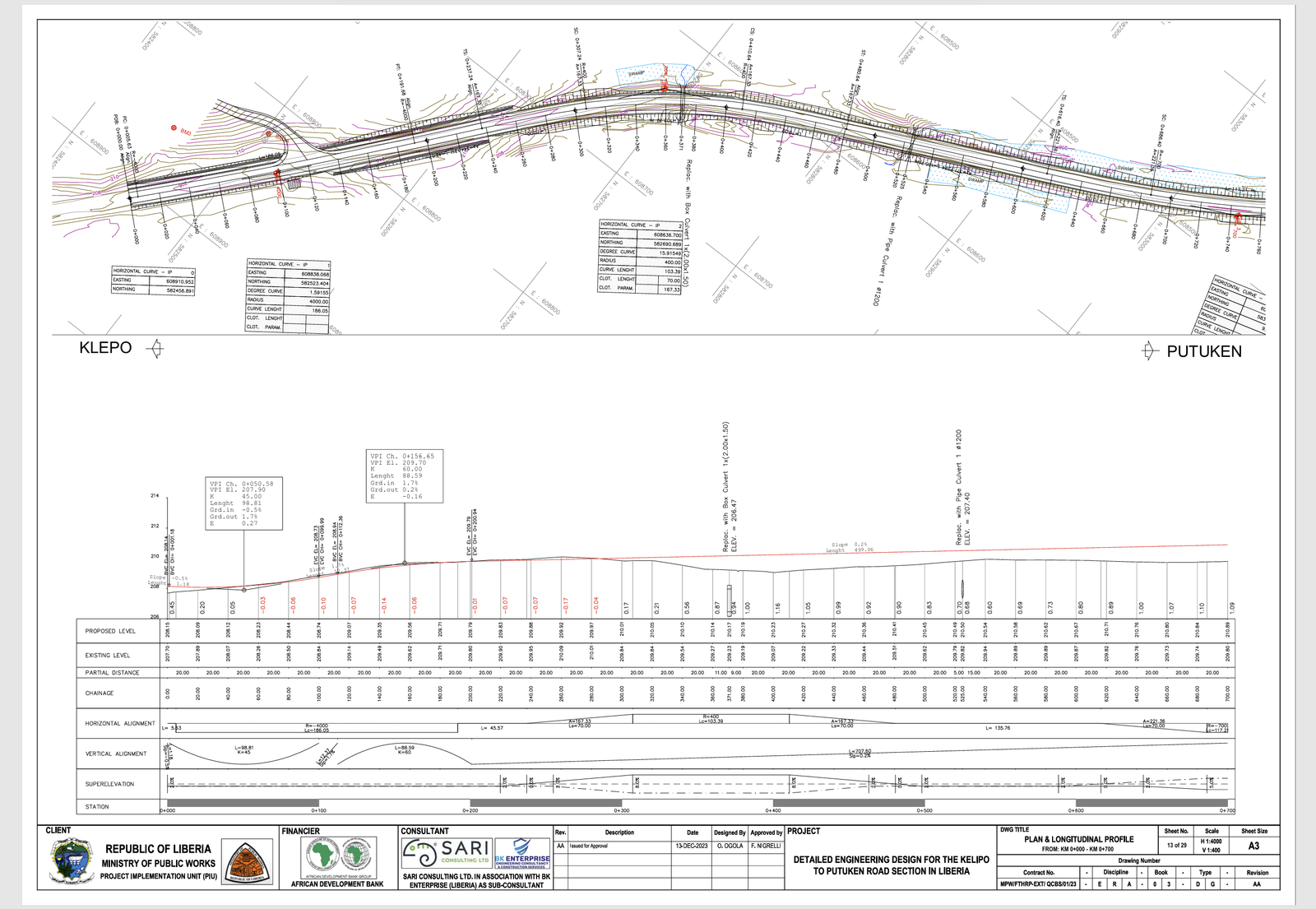

Geometric Design
Project Significance: The completion of this design project lays the groundwork for transforming southeast Liberia's infrastructure, improving regional mobility, market access, and socio-economic development.
Project Name: Saclepia to Tappita Highway (SECRAMP)
Client: Infrastructure Implementation Unit (IIU), Ministry of Public Works Consultant: SARI Consulting Ltd in association with BK Enterprise Inc. Length: ~61 km Contract Signed: November 25, 2021 Commencement Date: February 1, 2022
📊 Work Progress (as of September 6, 2025)
Clearing & grubbing: 61.33 km (100%)
Base course: 52.87 km (86.21%)
Subbase – first layer: 60.71 km (98.9%)
Subbase – second layer: 54.71 km (89.21%)
Subgrade: 60.71 km (99%)
Binder course: 52.80 km (86.09%)
Wearing course: 49.57 km (80.83%)
Pipe culverts: 100 (100%)
Box culverts: 13 (100%)
Road marking: Completed up to Km94 where wearing course installed
🌉 Outstanding Works
The major outstanding component is the construction of Bridge No. 1 (Two-span, 2x20m) at Km40+429.
Design completed
Precast platform completed
Preparation for reinforced steel underway
Total Physical Progress: 91.32%

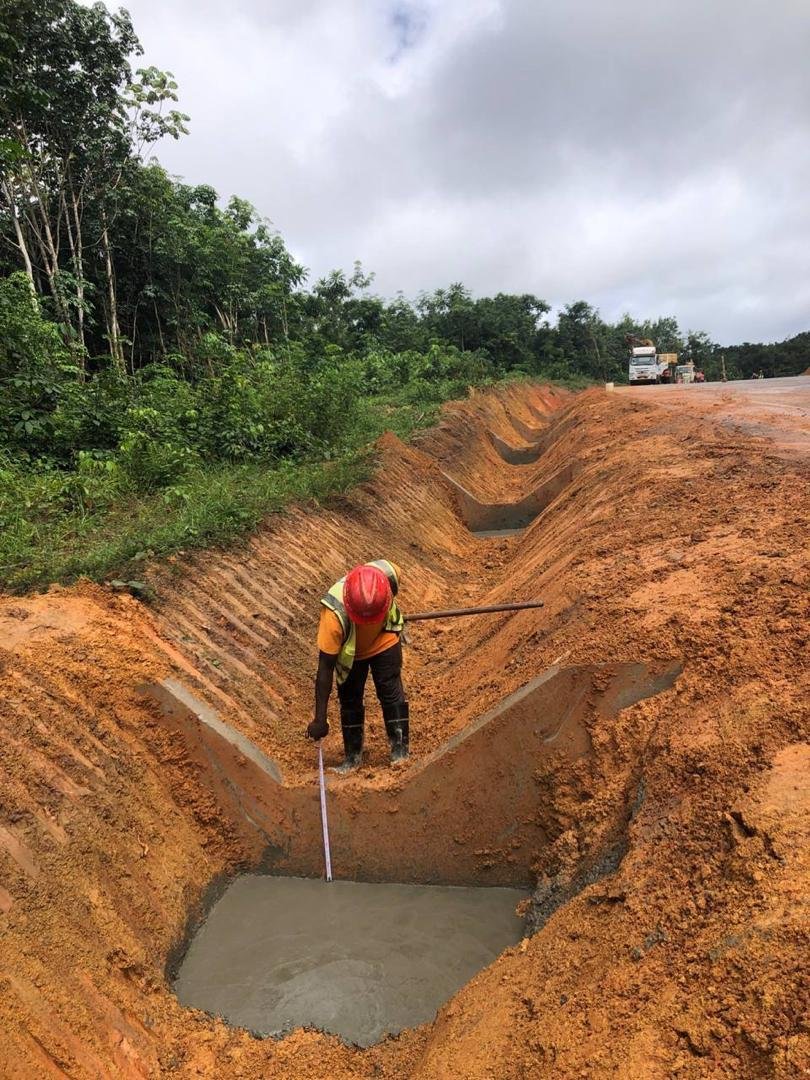

Saclepia–Tappita Highway Works
Strategic Impact: The road will enhance inter-county access, reduce travel time, promote trade and agriculture, and link remote regions to the national highway network.
